Hot Springs Southeast

The Hot Springs Southeast (rural) will be upgraded to fiber in 2025. This will complete the upgrade of the Hot Springs exchange.

Contractors:
Wiring Contractor – Vantage Point
Engineering Consultant – Heberly & Associates
Construction Contractor – MasTec North America

Overview Video Update Contact Information

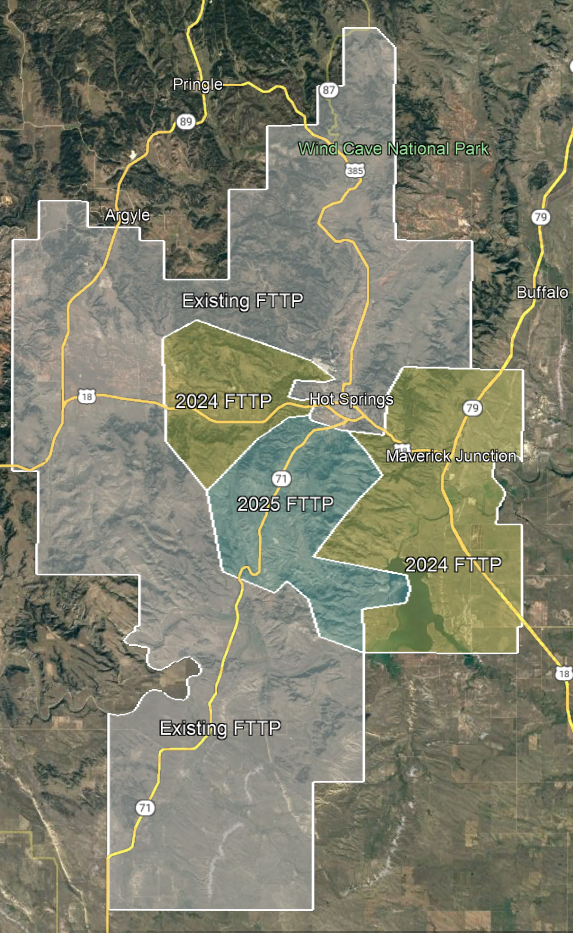

Hot Springs Phase 1 2024 FTTP.PNG

Project Updates:

July 24, 2025

  • MasTec has a directional drilling crew working on the west side of Cascade Road between Horseshoe Bend Road and the road to the Nature Conservancy. This crew will move to Shep’s Canyon Road between Hargins and Lake Hills Roads.
  • The mainline plow crew is plowing and pulling cable along Shep’s Canyon Road between Hargins and Lake Hills Roads. They will also be working on private drives off these roads.
  • A crew is burying lines to customer homes on Shep’s Canyon Road and Shep’s Canyon Cove Court again this week.
  • The rock saw crew will be working along Cascade Road and private driveways along Cascade Road between Black Hills Flyaway and Whaley Canyon Roads.
  • If you have questions about the Fiber to the Home project, please call Golden West at 1-855-888-7777 and ask for the engineering department.

Hot Springs 2025 construction 7-24-25.png

July 17, 2025

  • MasTec has a directional drilling crew working on the west side of Cascade Road between Shep’s Canyon Road and the road to the Nature Conservancy.
  • The mainline plow crew is plowing and pulling cable along Shep’s Canyon Road between Morning Star Trail and Lake Hills Road. They will also be working on private drives off these roads.
  • A crew is burying lines to customer homes on Shep’s Canyon Road and Shep’s Canyon Cove Court.
  • The rock saw crew will be working along Cascade Road and private driveways along Cascade Road between Shep’s Canyon and Black Hills Flyaway Roads.
  • If you have questions about the Fiber to the Home project, please call Golden West at 1-855-888-7777 and ask for the engineering department.

Hot Springs 2025 construction 7-16-25.png

July 10, 2025

  • MasTec has a directional drilling crew working on the west side of Cascade Road between Shep’s Canyon Rd and the road to the Nature Conservancy. They will also be working along Horseshoe Bend Road.
  • The mainline plow crew is plowing and pulling cable along Cascade Road between Horseshoe Bend Road and the Nature Conservancy. This crew is also placing cable along Horseshoe Bend Road and private drives along these roads.
  • A crew is burying lines to customer homes on Cascade, Jenny, West Cascade Mountain, and East Cascade Mountain Roads.
  • A second crew is placing drops along Lakeview Drive, Lazy Bay Road, S Boat Ramp Road, and Waters Edge Boulevard.
  • The rock saw crew will be working along Cascade Road.
  • If you have questions about the Fiber to the Home project, please call Golden West at 1-855-888-7777 and ask for the engineering department.

Hot Springs 2025 construction 7-10-25.png

June 26, 2025

  • MasTec has a directional drilling crew working on the west side of Cascade Road between Shep’s Canyon Rd and the road to the Nature Conservancy.
  • The mainline plow crew is plowing and pulling cable along Shep’s Canyon and Horseshoe Bend Roads as well as private drives off these roads.
  • Crews are burying lines to customer homes on Cascade, Pine Shadows, Jenny, Forest, and Himmelwright Roads.
  • The pre-rip crew is working along private drives and county roads along Cascade Road.
  • Construction crews will be away next week. They will return on July 7th.
  • If you have questions about the Fiber to the Home project, please call Golden West at 1-855-888-7777 and ask for the engineering department.
